Construction at the Kōloa Village Residential Project in Kaua‘i continued to advance throughout October, with steady progress across sitework, vertical construction, and interior building activities. Based on the latest inspection by Karl’s Construction Services, overall development remains in general compliance with design specifications and County regulations, with active work occurring across multiple buildings.
Sitework and Vertical Construction

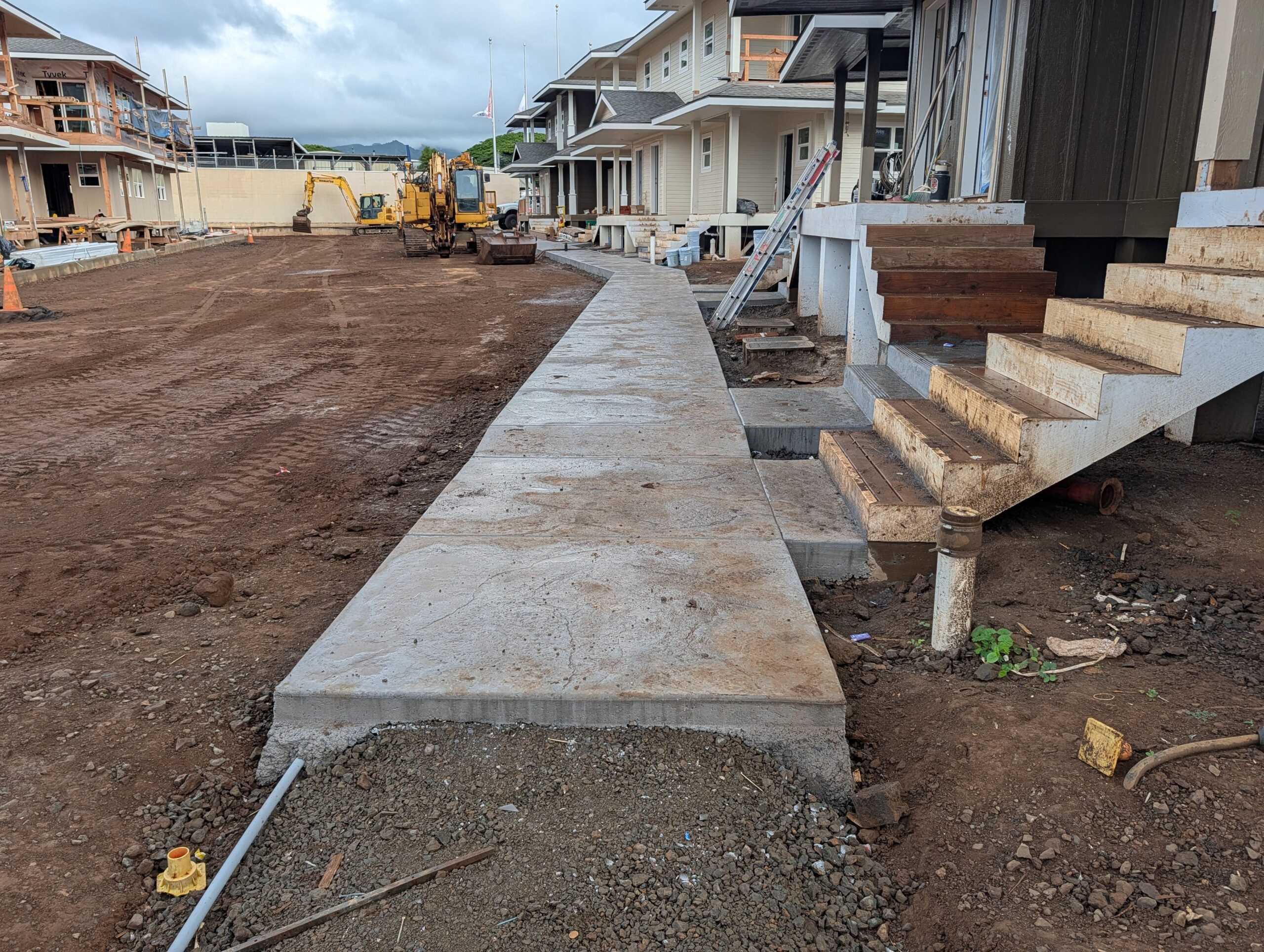

Sitework, which began in Fall 2024, is now largely complete, with sidewalks and major grading activities finalized. Only a few remaining driveway sections are scheduled for completion in November.

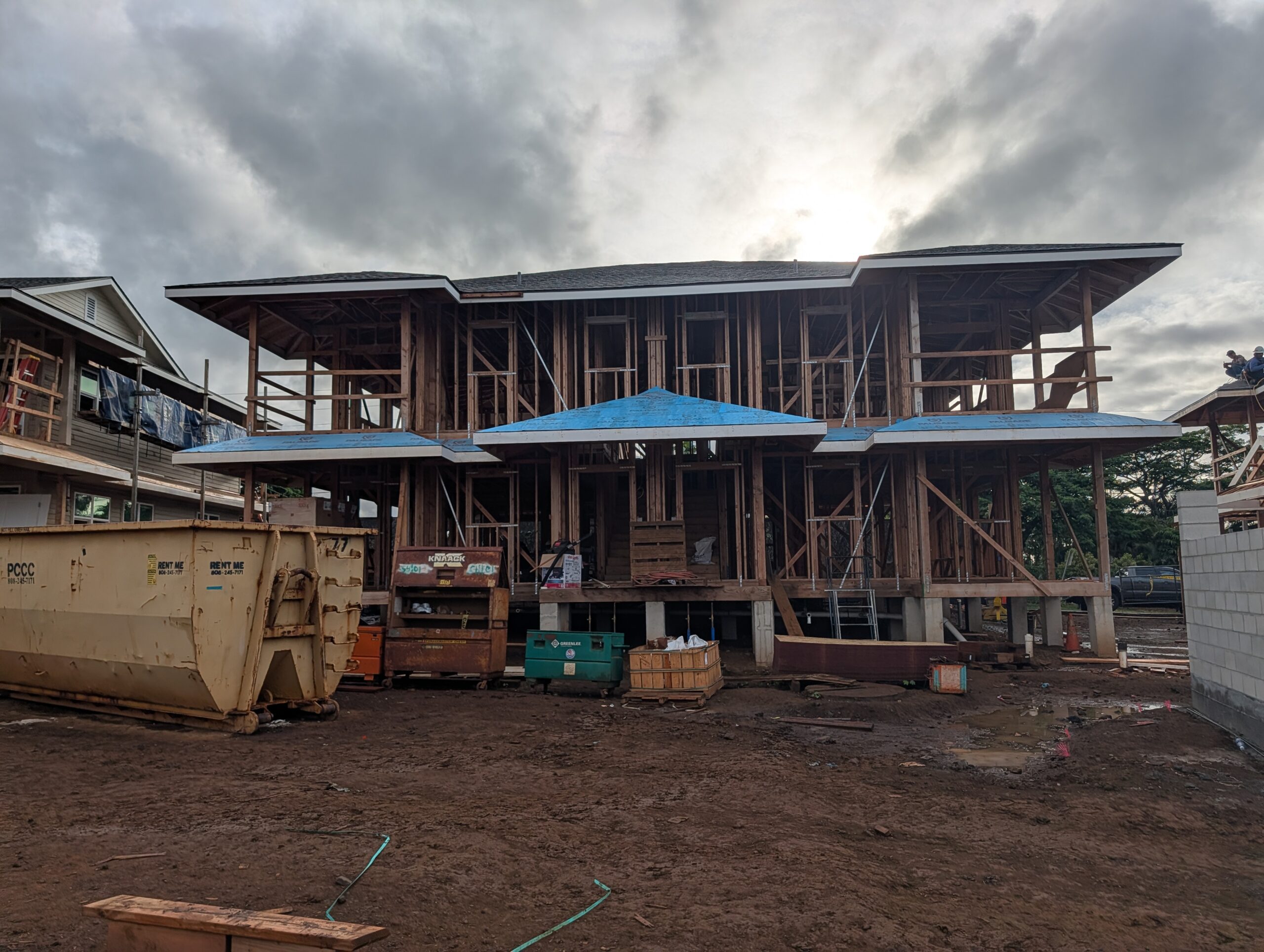

Vertical construction, which began in early 2025, continues to progress without major delays. Framing and roofing have advanced across several buildings, including A, B, C, D, E, M, N, and R. Interior rough-in work is underway in these buildings, followed by insulation, drywall, and early-stage finishing.
Framing is also progressing for Buildings F and G, with Building P beginning framing activities. Preparations are ongoing for subsequent buildings in accordance with the revised construction sequence.
Permits and Compliance
All required County permits have been issued for both grading and vertical construction. County inspectors continue to visit the site regularly, and all required special inspections are being completed as needed.
Environmental controls remain fully in place, including perimeter dust screens, tire-cleaning aprons at site entrances, and silt fencing. These measures are being maintained properly and remain compliant with regulatory requirements.
Progress by Trade
Key construction activities observed during October include:
- Framing & Trusses: Structural framing completed across the first group of buildings; framing continues on remaining structures.

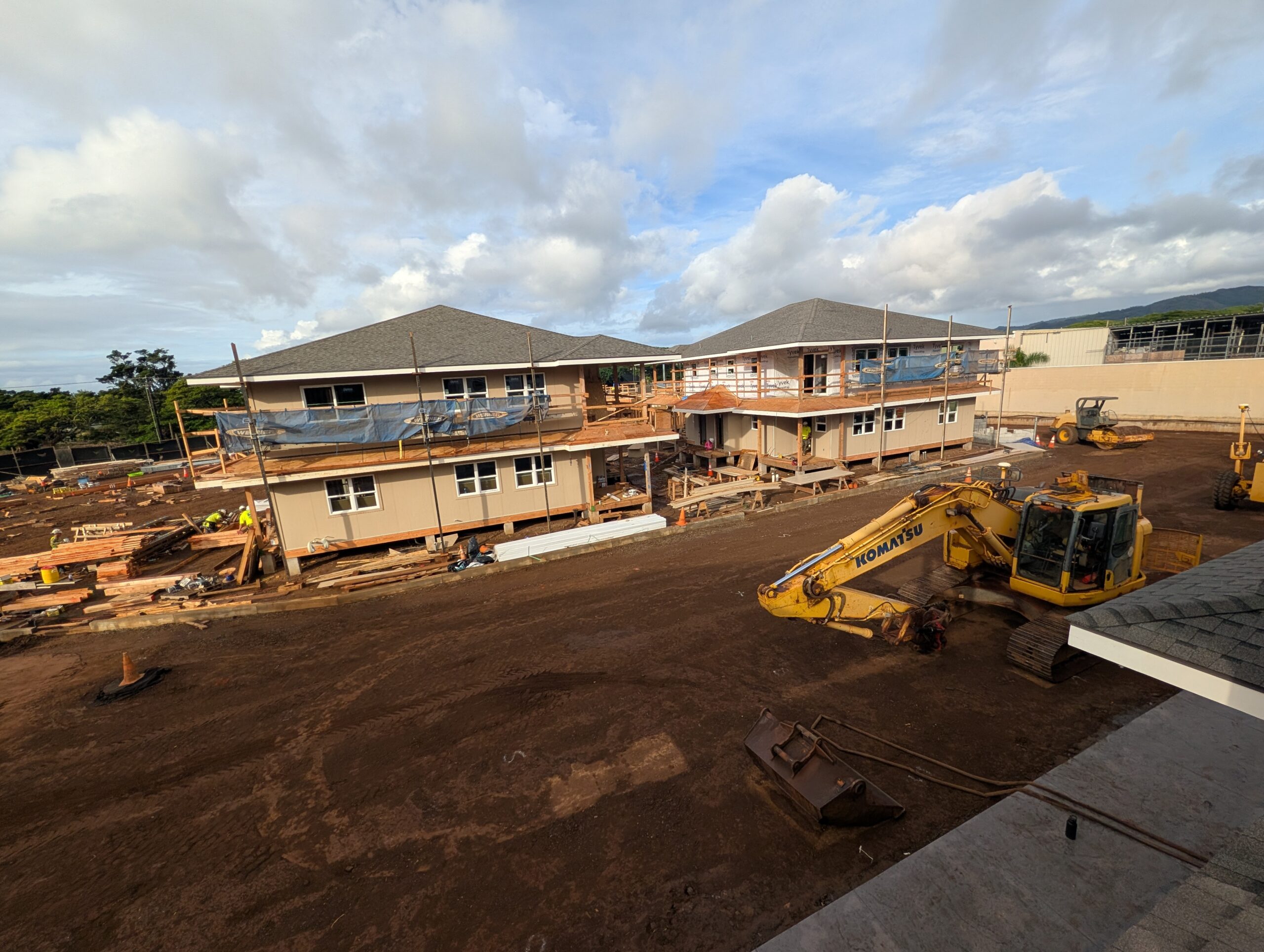

- Roofing: Roofing work progressing following truss installation, with several buildings nearing completion.

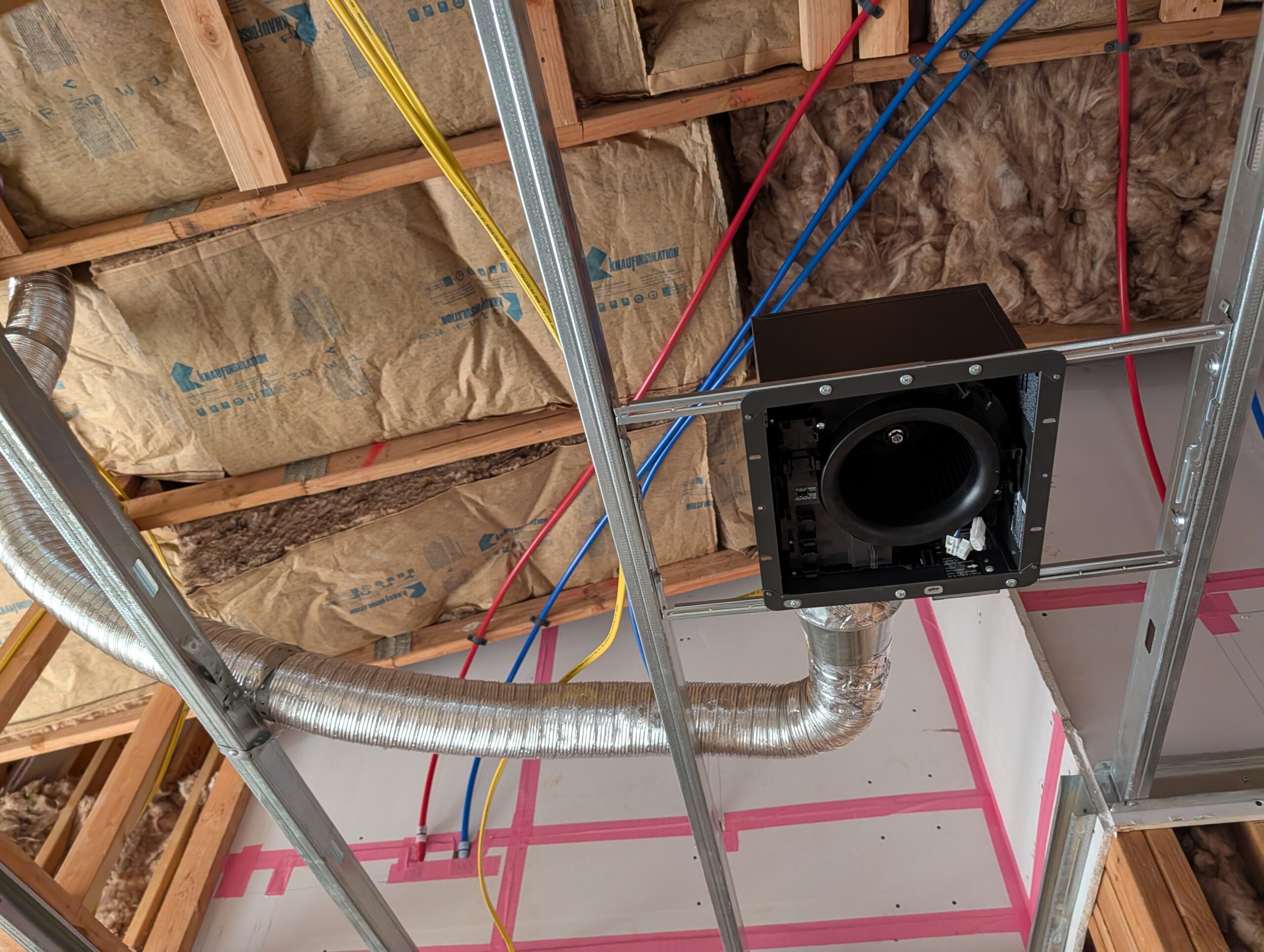

- Insulation & Drywall: Interior rough-ins underway; insulation and drywall installation active in multiple units.

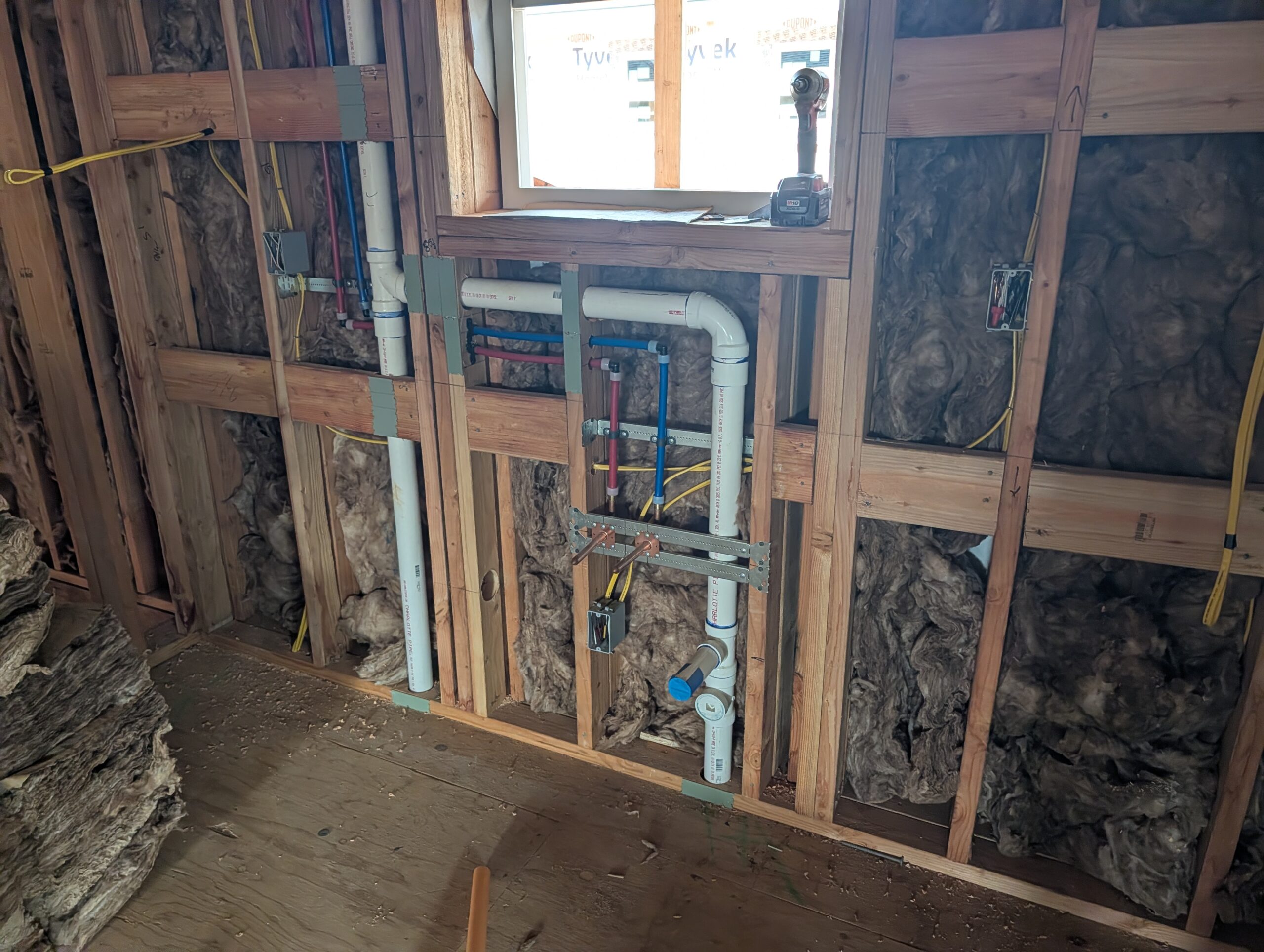

- Electrical & Plumbing: Rough-in work continues across all active buildings, including underground systems.
- Exterior Finishes: Siding and exterior painting are advancing steadily as buildings move toward the finish stage.
Quality, Safety, and Schedule
Work quality remains consistent with industry standards, and the contractors on-site continue to follow effective quality control programs. Construction activities observed during October reflect general compliance with the project’s plans and specifications.
There have been no reportable accidents, and overall site security remains strong. Secure storage units and field offices remain active both on-site and at the off-site contractor staging area.
While work is slightly behind the earliest projected schedule, the contractor continues to target completion of initial buildings around early 2026. The overall project schedule still makes completion of the residential phase by Spring 2026 feasible.
Financial Overview
The most recent contractor pay application reflects consistent financial progress aligned with on-site work completed through the end of October. The project remains within expected budget parameters, and available funding continues to support all construction activities without interruption. Vendor invoices reviewed during this cycle align with observed progress.
Summary
Overall, construction at Kōloa Village continued in line with expectations during October. Multiple buildings have advanced into interior stages, while ongoing framing and roofing keep the remaining structures on track. Coordination between contractors, inspectors, and the project team remains strong, supporting continued progress toward projected completion in 2026.
This update is based on the October 2025 inspection report prepared by Karl’s Construction Services, LLC. The content is for informational purposes only and does not constitute legal, financial, or investment advice. All progress information is subject to change based on site conditions and official project updates.
